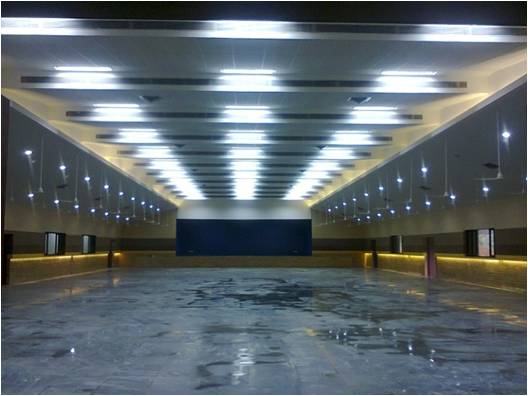

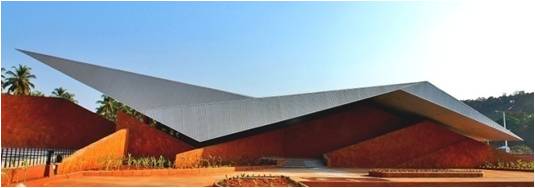

Status
100%
Completed

Project highlights

Construction of Bus stand having provison of 10 parking bay for buses, 4 commercial shops and other facilities. A mutipurpose hall with seating capacity of 800 with stage and changing rooms is attached to the Bus stand.




Sub Works

This project involved 5 sub works. The details of the same available below

1

Phase I : Land Development.

100% completed

Project Duration
Stipulated Date of Commencement November 06 2008
Stipulated Date of Completion /
Likely Date of Completion
March 05 2009
Status
100%
Completed
Cost (₹)
Estimated at ₹ 7,891,687.00
Awarded for ₹ 7,300,000.00
Final Cost of Project ₹ 4,623,023.00

Contractors
M/s. Rohit Equipments
Consultants
M/s. Rahul Deshpande & Associates
2

Civil & Electrical works

100% completed

Project Duration
Stipulated Date of Commencement November 25 2010
Stipulated Date of Completion /
Likely Date of Completion
March 11 2013
Status
100%
Completed
Cost (₹)
Estimated at ₹ 6,07,10,082.00
Awarded for ₹ 6,22,69,573.00
Final Cost of Project ₹ 86,264,969.00

Contractors
M/s. Shilpi Constructions
Consultants
M/s. Rahul Deshpande & Associates
3

HVAC work.

100% completed

Project Duration
Stipulated Date of Commencement March 25 2012
Stipulated Date of Completion /
Likely Date of Completion
December 12 2013
Status
100%
Completed
Cost (₹)
Estimated at ₹ 3,420,639.00
Awarded for ₹ 3,539,999.00

Project highlights

Air conditioning works for Multipurpose hall


Contractors
M/s. Aprant Motors Pvt. Ltd.
Consultants
M/s. Rahul Deshpande & Associates
4

Acoustic work for Multipurpose Hall.

100% completed

Project Duration
Stipulated Date of Commencement May 06 2012
Stipulated Date of Completion /
Likely Date of Completion
April 13 2013
Status
100%
Completed
Cost (₹)
Estimated at ₹ 7,551,260.00
Awarded for ₹ 7,326,587.00
Final Cost of Project ₹ 6,778,285.00

Project highlights

Acoustic works for Multipurpose hall


Contractors
M/s. R. S. Lawande
Consultants
M/s. Rahul Deshpande & Associates
5

External Electrical Work

100% completed

Project Duration
Stipulated Date of Commencement January 14 2013
Stipulated Date of Completion /
Likely Date of Completion
December 12 2013
Status
100%
Completed
Cost (₹)
Estimated at ₹ 3,848,415.93
Awarded for ₹ 4,426,921.55

Project highlights

External Electrical Work


Contractors
M/s. Ohm Engineers & Electricals Pvt. Ltd.
Consultants
M/s. Rahul Deshpande & Associates
